FY2025 FEMA Procurement Policy Implementation Framework
Synergized, De-Duplicated, and Reorganized GOVSTAR Guide
Purpose: Convert the source PDF into a logical, flowing, publication-ready guide with consolidated headings, CTA takeaways, and redundancy review notes.
Core CTA: Treat FEMA procurement compliance as an upfront grant-protection system, not a closeout paperwork exercise. Every procurement file should be built so that an auditor can understand the authority, method, competition, price reasonableness, contract clauses, conflict checks, and performance oversight without reconstruction years later.
Abstract Summary
The source document presents FEMA procurement compliance as a mandatory funding-preservation framework for recipients and subrecipients using FEMA assistance. Its central message is that procurement is not merely an administrative purchasing function; it is a grant-eligibility control system tied directly to 2 C.F.R. Part 200, FEMA policy guidance, and audit defensibility.
The strongest CTA is to institutionalize procurement controls before disaster contracting begins: written standards of conduct, conflict-of-interest screening, full and open competition, correct procurement method selection, cost or price analysis, required contract clauses, documentation, and ongoing contractor oversight. These controls should be embedded in templates, checklists, pre-disaster contracting files, and legal review protocols.
The document contains useful content but repeats several themes in overlapping sections. This consolidated version reorganizes the material from a repeated topic-by-topic note set into a logical operational sequence: applicability, governance, competition, procurement methods, contract provisions, cost analysis, specialized procurement scenarios, audit readiness, and CTA implementation.
Reorganized Table of Contents
- Purpose, Scope, and Regulatory Applicability
- Governance Controls: Conduct, Conflicts, and Oversight
- Competition Rules and Procurement Method Selection
- Required Contract Clauses and Federal Compliance Layers
- Cost, Price, Documentation, and Audit-Ready Files
- Special Procurement Situations and Higher-Risk Scenarios
- FEMA Review, Remedies, and Noncompliance Consequences
- Consolidated Implementation Checklist and CTA Takeaways
- Redundancy Review Notes
- Purpose, Scope, and Regulatory Applicability
- This guide establishes a consolidated framework for FEMA-funded procurement compliance. It is designed for recipients, subrecipients, local governments, nonprofit organizations, tribal entities, grant managers, finance officers, legal counsel, procurement officials, and program staff responsible for disaster-related contracting.
- The key operating principle is simple: procurement compliance must be proven at the time of purchase, not reconstructed after FEMA, a pass-through entity, DHS OIG, or an auditor asks for the file. The procurement file should show why the purchase was necessary, why the method was allowed, how competition was achieved, why the price was reasonable, which contract clauses applied, and how performance was monitored.
- CTA: Build every FEMA-funded procurement file as if it will be reviewed independently by FEMA or DHS OIG. The file should explain the decision without relying on institutional memory.
- Regulatory foundation
- The source document identifies the July 2025 FEMA Procurement Under Grants Policy Guide as the controlling policy framework for awards and Stafford Act declarations within its effective scope. It connects the guide to the federal procurement standards in 2 C.F.R. Part 200 and emphasizes that these standards affect reimbursement eligibility, audit risk, and cost allowability.
- The document repeatedly frames procurement compliance as a condition of federal reimbursement. That message should remain prominent, but the consolidated structure treats it as the legal foundation rather than repeating it in every section.

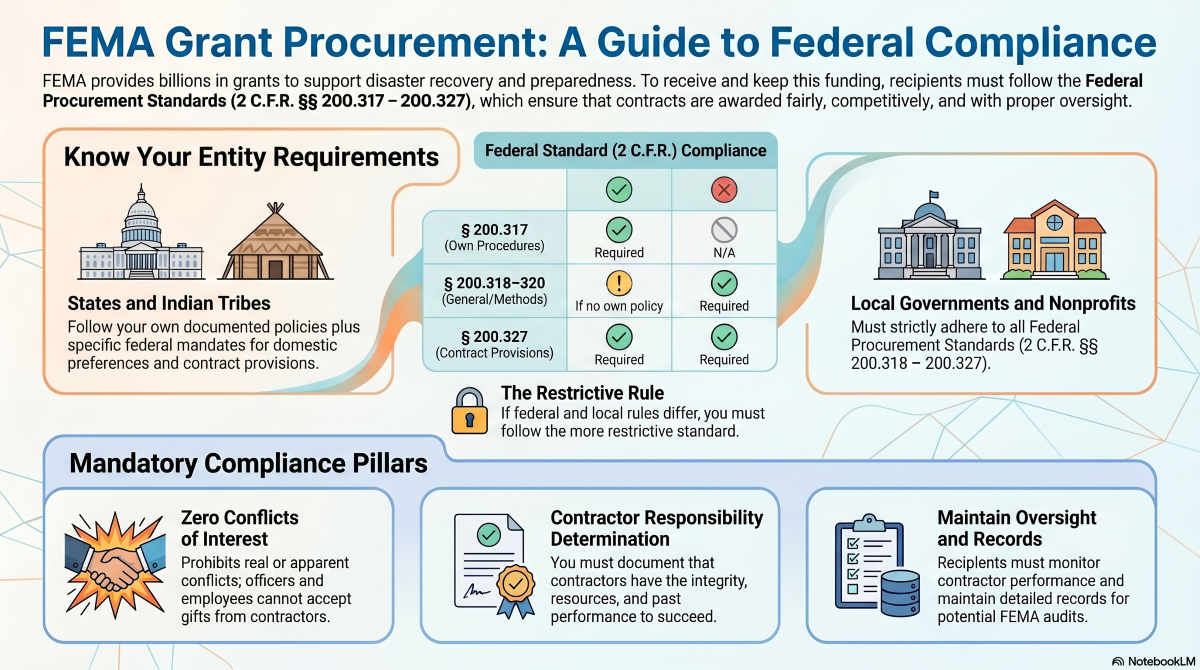

- Applicability by entity type
- Entity Type
- Primary Authority
- Core Requirement
- Non-Negotiable Federal
- Mandates
- States and Indian Tribes
- 2 C.F.R. § 200.317
- Follow their own documented procurement policies.
- Comply with domestic preference and required contract provision
- requirements.
- Local Governments and Nonprofits
- 2 C.F.R. §§ 200.318-
- 200.327
- Follow the federal procurement standards and their own written procedures.
- Full adherence to the procurement method, competition, documentation, clause,
- and oversight requirements.
- Effective-date discipline
- The source document highlights the need to identify the correct guide version by federal award date and disaster declaration date. It also emphasizes that Hurricane Helene-related declarations are treated specially under FEMA direction so that the October 1, 2024 revisions apply regardless of whether the specific declaration preceded or followed that threshold.
- For operational use, the effective-date rule should be converted into a file-opening checklist item: every procurement file should include the applicable FEMA guide version, the award date, the declaration date, and any disaster-specific FEMA directive that changes normal applicability rules.
- Governance Controls: Conduct, Conflicts, and OversightThe governance layer is the first line of defense. Before choosing a procurement method or drafting a solicitation, the recipient must have written standards of conduct, conflict-of-interest controls, and an oversight model that assigns responsibility for compliance and performance.
- Written standards of conductLocal governments and nonprofits must maintain written standards governing employees, officers, and board members involved in procurement. These standards should prohibit real and apparent conflicts, define covered individuals, address gifts and gratuities, and specify disciplinary consequences for violations.
- Define who is covered, including employees, officers, board members, immediate family members, partners, and affiliated entities where applicable.
- Prohibit solicitation or acceptance of gifts, gratuities, favors, travel, hospitality, or items of monetary value from contractors or prospective contractors.
- Define any de minimis exception in writing, with clear dollar thresholds approved by counsel.
- Identify disciplinary actions for violations, including removal from procurement activity, employment action, contract remedies, and legal referral where appropriate.
- Conflict-of-interest architecture
- Conflict Type
- Trigger
- Required Control
- Real conflict
- A covered person has a financial interest or tangible personal
- benefit tied to a contractor.
- Disclosure, written evaluation, recusal, and retention in the
- procurement file.
- Apparent conflict
- A relationship creates the appearance of personal interest
- even without proven financial gain.
- Treat as an audit-risk issue; document mitigation and recusal.
- Organizational conflict
- An affiliate, parent, subsidiary, or contractor relationship impairs
- impartiality.
- Screen for impaired objectivity, unequal access to information,
- and biased ground rules.
- Biased ground rules / double dipping
- A contractor drafts the scope, specifications, or solicitation and then seeks to compete.
- Exclude the contractor from competing unless a specific, documented exception applies
- under the governing rules.
- Non-delegable oversight responsibilityThe source document repeatedly states that oversight is non-delegable. A recipient may hire technical advisors, purchasing agents, debris monitors, construction managers, or program managers, but it cannot transfer the underlying obligation to ensure contract compliance, performance, and fiscal accountability.
- Assign a responsible procurement owner for each FEMA-funded contract.
- Document performance monitoring, deliverable review, invoice approval, and change-order review.
- Acquire specialized expertise when internal staff are not qualified, especially for debris monitoring, engineering, construction, or complex grant-funded work.
- Avoid unnecessary or duplicative acquisitions and limit purchases to current disaster-related needs.
- CTA: Do not confuse outsourcing technical work with outsourcing responsibility. The recipient remains accountable for procurement compliance, contractor performance, and the reasonableness of costs.
- Competition Rules and Procurement Method SelectionThe procurement method must match the dollar threshold, factual circumstances, and competition requirements. The file must show that the chosen method was allowed and that the recipient avoided restrictive practices.
- Procurement methods and thresholds
- Method
- Threshold / Use
- Competition
- Requirement
- File Evidence
- Micro-purchase
- Under $10,000
- No quotes required if price is reasonable; distribute purchases among qualified suppliers where
- practicable.
- Price reasonableness note, supplier selection note, and distribution rationale when recurring.
- Simplified acquisition
- $10,000 to $250,000
- Obtain price or rate quotations from an adequate number of qualified sources; FEMA encourages at least
- three.
- Quotes, scope, supplier list, comparison, and selection rationale.
- Sealed bidding
- Over $250,000; clear specifications; price is primary factor
- Public solicitation; firm-fixed-price award to lowest responsive and
- responsible bidder.
- IFB, public notice, bids, responsiveness/responsibility review, bid tabulation, award
- decision.
- Proposals
- Over $250,000; price is not sole factor
- Public RFP; evaluation of technical and cost factors; award to most advantageous
- responsible offeror.
- RFP, evaluation factors, proposals, scoring, negotiation notes if applicable, award rationale.
- Noncompetitive procurement
- Only when a regulatory exception applies
- Allowed only under specific exceptions such as emergency/exigency, single source, inadequate competition, or express
- authorization.
- Separate written justification for each instance, exception basis, price analysis, and contract provisions.
- Restrictions to competitionThe source material identifies recurring practices that restrict full and open competition. These should be converted into a solicitation-drafting checklist.
- Do not impose unreasonable qualification requirements, excessive bonding, or unnecessary experience criteria.
- Do not use noncompetitive pricing practices such as bid rigging, bid suppression, complementary bidding, or bid rotation.
- Do not award broad, undefined work to a contractor on retainer without a compliant procurement for the actual work.
- Do not specify a brand name only unless an equivalent is allowed or a strong justification is documented.
- Do not use arbitrary actions, undocumented discretion, or post-submission evaluation changes.
- Keep prequalified lists current, open to new vendors during the solicitation period, and broad enough to maximize competition.
- Noncompetitive procurement disciplineNoncompetitive procurement is not a convenience method. Each use requires its own written justification, a clear regulatory basis, documentation of why competition was not feasible, and a fair-and-reasonable price determination.
- Confirm the procurement meets one of the allowed exceptions before work begins.
- Limit the scope and period to the actual emergency or exigent need.
- Transition to competitive procurement when the urgent condition no longer prevents competition.
- Maintain price or cost analysis and required contract provisions even when competition is not used.
- Document contractor selection or rejection rationale and any conflict review.
- CTA: Use noncompetitive procurement as a documented exception, not as an operational shortcut. FEMA reimbursement risk increases sharply when emergency facts are not tied to the scope, duration, and price of the contract.
- Required Contract Clauses and Federal Compliance LayersRequired clauses are a central audit checkpoint because FEMA is not a party to the recipient’s contract. The recipient must preserve its own legal remedies and incorporate federal provisions necessary for reimbursement eligibility.
- Required provisions by trigger
- Trigger
- Required / Typical Provision
- Why It Matters
- Contracts over $10,000
- Termination for cause and convenience
- Preserves the recipient’s ability to end nonperforming or no-longer-
- needed work.
- Contracts over $25,000
- Suspension and debarment
- verification
- Prevents award to excluded
- parties and supports eligibility.
- Contracts over $100,000
- Anti-lobbying certification and relevant labor provisions where
- applicable
- Addresses federal restrictions tied to contract size and funding.
- Contracts over $150,000
- Clean Air Act and Federal Water
- Pollution Control Act provisions
- Supports environmental
- compliance.
- Contracts over $250,000 / SAT
- Contract remedies clause
- Provides enforceable remedies for
- breach or nonperformance.
- Construction over $2,000 when applicable
- Davis-Bacon and Copeland Anti-Kickback clauses
- Addresses wage, labor, and anti-kickback requirements where
- triggered.
- Goods, products, and infrastructure materials where
- applicable
- Domestic preferences, BABAA, recovered materials, and
- telecommunications restrictions
- Ensures compliance with federal sourcing, environmental, and
- national-security restrictions.
- Domestic preferences, BABAA, and recovered materialsThe source document treats domestic preference, BABAA, and recovered materials as separate but related compliance layers. They should be managed through standard clause libraries, vendor certifications, and project-level applicability reviews.
- For domestic preference and BABAA applicability, confirm whether the procurement involves iron, steel, manufactured products, or construction materials for covered infrastructure work.
- Include required contract language and self-certification requirements where applicable.
- For recovered materials, prioritize EPA-designated products with practicable recovered material content when the requirement applies.
- Document non-availability, public interest, or cost-based waiver conditions when relying on a waiver.
- Prohibited and high-risk contract structuresThe document flags cost-plus-a-percentage-of-cost contracts as prohibited and identifies time-and-materials contracts as high-risk unless justified and capped. Contract type should be reviewed before execution, not after invoices are submitted.
- Avoid cost-plus-a-percentage-of-cost structures, including embedded subcontract mechanisms that increase profit as costs rise.
- Use time-and-materials contracts only when no other contract type is suitable and only with a ceiling price and oversight controls.
- For cost-reimbursement contracts, define allowable cost principles, documentation requirements, and invoice-review controls.
- For fixed-price contracts, ensure the scope is sufficiently defined and modifications are controlled.
- Cost, Price, Documentation, and Audit-Ready FilesCost and price analysis converts procurement decisions into audit evidence. The source document repeatedly identifies documentation as the bridge between procurement action and FEMA reimbursement eligibility.
- Independent estimates and price reasonablenessFor procurements above the Federal Simplified Acquisition Threshold, the file should include an independent cost estimate and a documented cost or price analysis. Price analysis may rely on comparison of offers, prior prices, market pricing, catalog pricing, or independent estimates. Cost analysis reviews individual cost elements and profit.
- Prepare an independent cost estimate before receiving bids or proposals when required.
- Use price analysis when comparing total prices without examining each cost element.
- Use cost analysis when price cannot be evaluated without reviewing labor, materials, equipment, overhead, and profit.
- Document why the selected procurement approach was economical, including any decision to break out scopes such as vegetative debris and construction debris.
- Required procurement file contents
- Applicable authority and FEMA guide version.
- Statement of need and confirmation that the acquisition is not unnecessary, duplicative, or for future stockpiling.
- Procurement method and threshold determination.
- Scope of work, specifications, solicitation, public notice, and response deadlines.
- Sources solicited, bids or proposals received, evaluation materials, and selection or rejection rationale.
- Conflict-of-interest disclosures, recusals, and organizational conflict review.
- Independent cost estimate, price analysis, or cost analysis.
- SAM.gov or debarment verification where required.
- Executed contract, required clauses, modifications, change orders, and performance documentation.
- Invoice review, deliverable acceptance, payment approval, and closeout records.
- CTA: The procurement file should tell the entire compliance story: need, authority, method, competition, evaluation, price, contract terms, performance, and payment.
- Special Procurement Situations and Higher-Risk ScenariosSeveral procurement contexts require additional controls because they frequently create competition, scope, or documentation problems.
- Architectural and engineering services
- The proposal method is generally appropriate for acquiring architectural and engineering professional services because qualifications, technical capacity, and past performance may be more important than lowest price. The solicitation must disclose evaluation factors and the file must show the written evaluation method.
- Bonding for constructionFor construction or facility improvement contracts above the Federal SAT, bonding requirements generally include bid guarantees, performance bonds, and payment bonds unless an accepted bonding policy adequately protects federal interests.
- Bid guarantee: commonly 5 percent of bid price.
- Performance bond: commonly 100 percent of contract price.
- Payment bond: commonly 100 percent of contract price.
- Document any accepted alternative bonding policy.
- Cooperative purchasing, piggybacking, and joint procurementCooperative purchasing may improve efficiency, but it does not eliminate federal procurement standards. Piggybacking on another contract is high-risk unless the original procurement was compliant, the scope aligns, and the contract permits the contemplated use.
- Verify that the original procurement met applicable federal standards.
- Confirm that the scope, price, term, options, and quantities cover the FEMA-funded need.
- Avoid out-of-scope modifications and cardinal changes.
- Document why cooperative or piggyback procurement is eligible and economical.
- Prepositioned contracts and emergency preparednessPrepositioned contracts are useful for rapid disaster response, but the source document warns that they must be procured before disaster using compliant procedures, reasonable prices, and clear scopes. Using a prepositioned contract outside its original scope can convert the work into a noncompetitive procurement.
- Maintain current, broad, and open prequalified lists when used.
- Allow potential bidders to qualify during the solicitation period unless a valid exception applies.
- Use short-term noncompetitive emergency work only when justified and transition to competition when feasible.
- Avoid treating prequalified lists as contracts; they are tools for competition, not substitutes for compliant award processes.
- Mutual aid and purchasing agents
- Mutual aid can support disaster operations, but procurement implications depend on whether FEMA funds pass through the requesting entity and whether contracts incidental to the mutual aid arrangement are being used.
- Purchasing agents may assist procurement activity, but cannot replace the responsible entity’s oversight or participate where conflicts exist.
- Telecommunications restrictions
- Federal funds may not be used for certain prohibited telecommunications equipment or services. Contract files should include a review step confirming that prohibited equipment, systems, or services are not being procured with FEMA funds.
- FEMA Review, Remedies, and Noncompliance ConsequencesThe source document emphasizes that FEMA and pass-through entities may review procurement specifications, solicitations, contracts, and supporting records. Reviews may occur before award, after award, during performance, at closeout, or in response to audit concerns.
- Pre-award reviews may focus on technical specifications, solicitation structure, and compliance gaps.
- Post-award reviews may focus on contract performance, modifications, invoices, and closeout documentation.
- FEMA may impose remedies such as withholding payments, disallowing costs, requiring additional reports, suspending or terminating awards, or initiating suspension/debarment actions.
- The practical risk is not limited to paperwork findings; the consequence can be loss of disaster recovery funding.
CTA: Assume FEMA will test both the decision and the documentation. A compliant procurement decision that is poorly documented can still become an audit vulnerability.
- Consolidated Implementation Checklist and CTA TakeawaysGovernance
- Written procurement procedures are current.
- Standards of conduct cover employees, officers, and board members.
- Conflict disclosures, recusals, and gift rules are documented.
- Procurement staff understand that oversight is non-delegable.
- Procurement Method
- The threshold and method are documented.
- Full and open competition is supported.
- Any noncompetitive procurement has a separate written justification.
- Prequalified lists remain open, current, and broad.
- Solicitation and Award
- Scope is clear and not restrictive.
- Evaluation factors are disclosed before responses are received.
- Sources are solicited adequately.
- Selection or rejection rationale is documented.
- Contract File
- Required federal clauses are included.
- SAM/debarment checks are complete where required.
- Bonding requirements are addressed for construction.
- Telecommunications, domestic preference, BABAA, and recovered-materials requirements are reviewed.
- Cost and Price
- Independent cost estimate is prepared where required.
- Price or cost analysis is documented.
- CPPC structures are prohibited.
- Time-and-materials contracts are justified, capped, and monitored.
- Performance and Closeout
- Performance is monitored.
- Invoices are reviewed against contract terms.
- Modifications are evaluated for scope and competition impacts.
- Records are retained for audit and closeout.
Final CTA Takeaways- Move procurement compliance upstream. The best FEMA procurement file is built before solicitation, not repaired after audit notice.
- Use standard templates: solicitation templates, contract-clause libraries, conflict forms, debarment checks, price-analysis worksheets, and contract-monitoring logs.
- Treat noncompetitive procurement as a narrow exception with a short factual shelf life.
- Build pre-disaster procurement capacity for debris, engineering, emergency protective measures, and other recurring disaster functions.
- Use legal and grants-management review for high-dollar, high-risk, noncompetitive, cooperative, piggyback, time-and-materials, or prepositioned contracts.
- Train program staff that procurement compliance is a financial protection tool: it protects reimbursement, avoids cost disallowance, and preserves disaster recovery capital.
- Redundancy Review Notes
The source PDF contained strong substantive material, but several themes were repeated across overlapping sections. The consolidated version preserves the substance while reducing repetition and improving flow.
Redundancy / Overlap Found
How It Was Consolidated
Resulting Placement
Purpose, overview, and applicability appeared in multiple
locations.
Merged into a single opening section with applicability and
effective-date discipline.
Section 1
Conflict of interest, standards of conduct, gifts, and double-dipping
overlapped.
Combined into a governance control architecture with a conflict
matrix.
Section 2
Competition restrictions appeared
under multiple headings.
Grouped into a single restrictions-
to-competition checklist.
Section 3
Procurement methods and thresholds were repeated in
narrative and checklist form.
Converted into one threshold table and practical file-evidence
requirements.
Section 3
Required clauses appeared in
narrative and appendix-style lists.
Consolidated into a trigger-based
clause table.
Section 4
Cost/price analysis and documentation were repeated across proposal, noncompetitive,
and checklist sections.
Reframed as an audit-ready file standard that applies across methods.
Section 5
Prequalified lists, prepositioned contracts, cooperative purchasing, and mutual aid were
scattered.
Reorganized as higher-risk special procurement scenarios.
Section 6
Key policy messages repeated as
“so what” points.
Converted into explicit CTA boxes
and a final CTA takeaway section.
Sections 1-8
Note: This consolidated guide is a drafting and organization aid based on the uploaded GOVSTAR procurement PDF. It should be reviewed against the current FEMA guide, award documents, state or local procurement law, and counsel before publication or operational use.
This document outlines federal procurement standards and guidelines for recipients of federal financial assistance to ensure proper, fair, and efficient procurement practices.
Procurement Standards Overview
This section outlines the federal requirements and standards for procurement processes under federal awards, emphasizing competition, responsible contracting, and compliance.
Procurements by States and Indian Tribes
States and Indian Tribes must follow their own policies or federal standards for procurement transactions.
- Must adhere to their existing policies; if none, follow §§ 200.318-200.327.
- Must comply with §§ 200.321, 200.322, 200.323, and 200.327.
- All subrecipients must follow §§ 200.318-200.327.
General Procurement Standards and Oversight
Recipients must maintain documented procedures, oversight, and standards to prevent conflicts of interest.
- Maintain written procurement procedures consistent with laws and standards.
- Oversight required to ensure contractor performance.
- Must have standards for conflicts of interest, organizational conflicts, and disciplinary actions.
- Avoid unnecessary or duplicative items; consider leasing vs. purchasing.
- Encourage strategic sourcing and use of excess Federal property.
- Use value engineering clauses for cost reduction.
- Award only to responsible contractors considering integrity, performance, and resources.
- Maintain detailed procurement records.
- Time-and-materials contracts allowed only with a ceiling price and high oversight.
- Responsible for settling contractual issues and reporting violations.
- Can use project labor agreements and hiring preferences if consistent with laws.
Competition Requirements in Procurement
Procurements must be conducted with full and open competition, avoiding unfair practices.
- Ensure objective performance and prevent unfair advantages.
- Exclude spec developers from competing.
- Avoid unreasonable requirements, noncompetitive pricing, and brand-name specifications.
- Require clear solicitations with technical descriptions and evaluation criteria.
- Maintain current prequalified lists to maximize competition.
- Can develop scoring mechanisms for worker protections, consistent with laws.
- Noncompetitive procurement only under specific circumstances.
Procurement Methods and Thresholds
Defines informal, formal, and noncompetitive procurement methods based on transaction value.
- Micro-purchases: aggregate amount does not exceed the micro-purchase threshold; can be awarded without competition if price is reasonable.
- Thresholds can be increased up to $50,000 with justification; above $50,000 require agency approval.
- Simplified acquisitions: between micro-purchase and simplified acquisition thresholds; require price quotes.
- Formal methods: used above simplified thresholds, including sealed bids and proposals.
- Sealed bids: used when specifications are complete, and price is primary factor.
- Proposals: used when sealed bids are not suitable; evaluated on multiple factors.
- Noncompetitive: only when transaction is below micro-purchase threshold, single source, emergency, written approval, or inadequate competition.
Contracting with Small and Minority Businesses
Recipients should consider small, minority, women’s, veteran-owned, and labor surplus firms.
- Include these businesses on solicitation lists.
- Solicit them whenever eligible.
- Divide procurements to maximize participation.
- Establish delivery schedules favoring these businesses.
- Use organizations like SBA and Minority Business Development Agency.
- Require contractors to apply these considerations to subcontracts.
Domestic Preferences in Procurement
Encourages preference for U.S.-made goods and materials.
- Prefer goods produced in the U.S., including iron, steel, cement, and manufactured products.
- “Produced in the U.S.” means all manufacturing processes occurred domestically.
- Applies to infrastructure projects under Buy America policies.
Procurement of Recovered Materials
Promotes procurement of recycled, reused, or sustainable products.
- State and local agencies must comply with the Solid Waste Disposal Act.
- Procure items with high recycled content when cost-effective.
- Maximize energy and resource recovery.
- Encourage use of products that are reusable, recyclable, or energy-efficient.
Contract Cost and Price Analysis
Require independent cost or price analysis for transactions over the simplified acquisition threshold.
- Analyze costs or prices based on facts and estimates.
- Costs based on estimates are allowable if compliant with subpart E.
- Prohibit “cost plus a percentage of cost” and “percentage of construction costs” contracts.
Federal Review of Procurement
Federal agencies may review procurement specifications and documents.
- Review to ensure specifications match proposed acquisitions.
- Can review before or after solicitation development.
- Exempt if procurement systems meet standards or are self-certified.
- Agencies may conduct pre-procurement reviews for high-dollar or non-compliant procurements.
Bonding Requirements for Construction
Federal agencies may accept bonding policies; otherwise, minimum requirements apply.
- Bid guarantee: 5% of bid price via bond or check.
- Performance bond: 100% of the contract price to secure contractor’s fulfillment.
Payment Bond Requirements for Contractors
A payment bond guarantees payment for labor and materials supplied during a contract, covering 100% of the contract price. - A payment bond is executed in connection with a contract. - It assures payment as required by law. - It covers all persons supplying labor and materials. - The bond amount equals 100% of the contract price.
Contract Provisions Mandated by Regulations
Contracts must include specific provisions outlined in Appendix II of the relevant regulation. - Recipient's or subrecipient's contracts are required to contain applicable provisions. - These provisions are detailed in Appendix II of the regulation. - Ensures compliance with federal requirements. - Promotes standardization across contracts.
