Welcome to the operational deep dive into the FEMA Force Account Playbook. As a Senior Disaster Recovery Compliance Expert, I cannot overstress the importance of the Public Assistance Program and Policy Guide (PAPPG) version 5 framework. The "Force Account" represents an applicant’s own internal resources—labor, equipment, and supplies. This playbook isn't just a guide; it is a defensive operational blueprint. In the world of federal recovery, the difference between a fully funded project and a massive de-obligation often comes down to how well an organization navigates these rigorous reimbursement standards before the first person is even deployed.
The "Force Account" concept is the bedrock of self-performed disaster work. Under PAPPG v5, FEMA requires a structured "Operational Blueprint" to distinguish disaster-specific costs from normal, day-to-day operational expenses.
This reference matrix ensures that internal assets—the very people, machines, and consumables you rely on—are tracked with the level of precision required for federal reimbursement. Every hour logged and every gallon of fuel used must be grounded in an audit trail that proves the resource was necessary, used specifically for the declared incident, and priced according to validated standards.
The "So What?" Layer: FEMA does not reimburse based on "good faith" or the intensity of your response; they reimburse based on the audit-readiness of your documentation. Without a structured playbook, applicants often find that their internal record-keeping fails to meet federal thresholds. If you cannot provide a clear, pre-existing policy or an itemized audit trail, FEMA’s default position is to deny the claim. Failing to institutionalize these standards early results in a permanent loss of funding that no amount of retroactive paperwork can fix.Connective Tissue: To protect your recovery funding, we must move beyond a reactive stance and master the four-stage lifecycle of compliance, which we call the Compliance Blueprint.

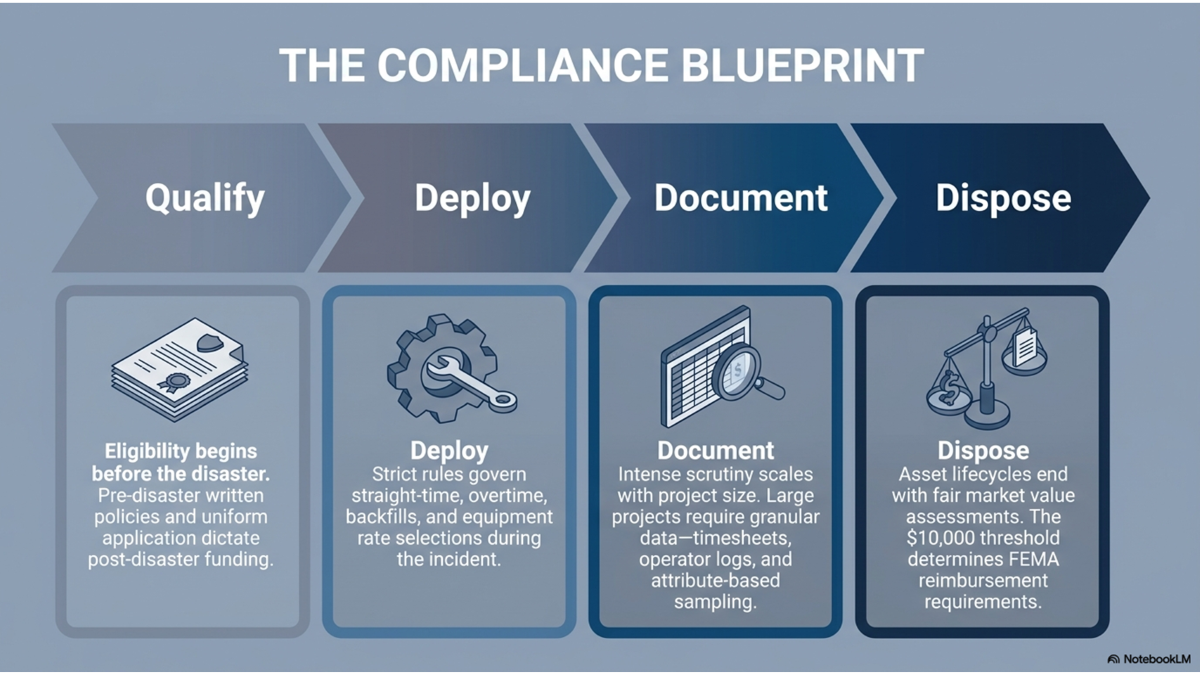

The Compliance Blueprint defines the lifecycle of a disaster project through four distinct phases: Qualify, Deploy, Document, and Dispose. From a compliance perspective, the "Qualify" stage is the most critical because it occurs before the disaster. If your pre-disaster policies are not the bedrock of your operation, the entire funding structure for the remaining stages will collapse under federal scrutiny.
Eligibility is won or lost in the Qualify stage. This is where your written pay policies and uniform application rules are established; these dictate all post-disaster funding. During the
Deploy stage, we activate the strict rules governing straight-time, overtime, and equipment rate selections. As work matures, the Document stage takes over, where intense scrutiny scales with project size—large projects require granular data like individual timesheets and operator logs.
Finally, the Dispose stage marks the end of an asset’s lifecycle, where we use fair market value assessments to determine if funds must be returned to the federal government.The "So What?" Layer: The $10,000 threshold mentioned in the "Dispose" phase is a high-stakes pivot point for scrutiny. If an unused supply or a piece of equipment maintains a fair market value over $10,000, FEMA requires compensation. More importantly, if your "Document" phase fails the "attribute-based sampling" used by auditors, the entire project’s funding is at risk. Policies must be in effect before the incident; without them, FEMA defaults to the most restrictive possible reimbursement rates.Connective Tissue: While the lifecycle provides the timeline, the complexity begins with our most expensive and scrutinized resource: Force Account Labor.

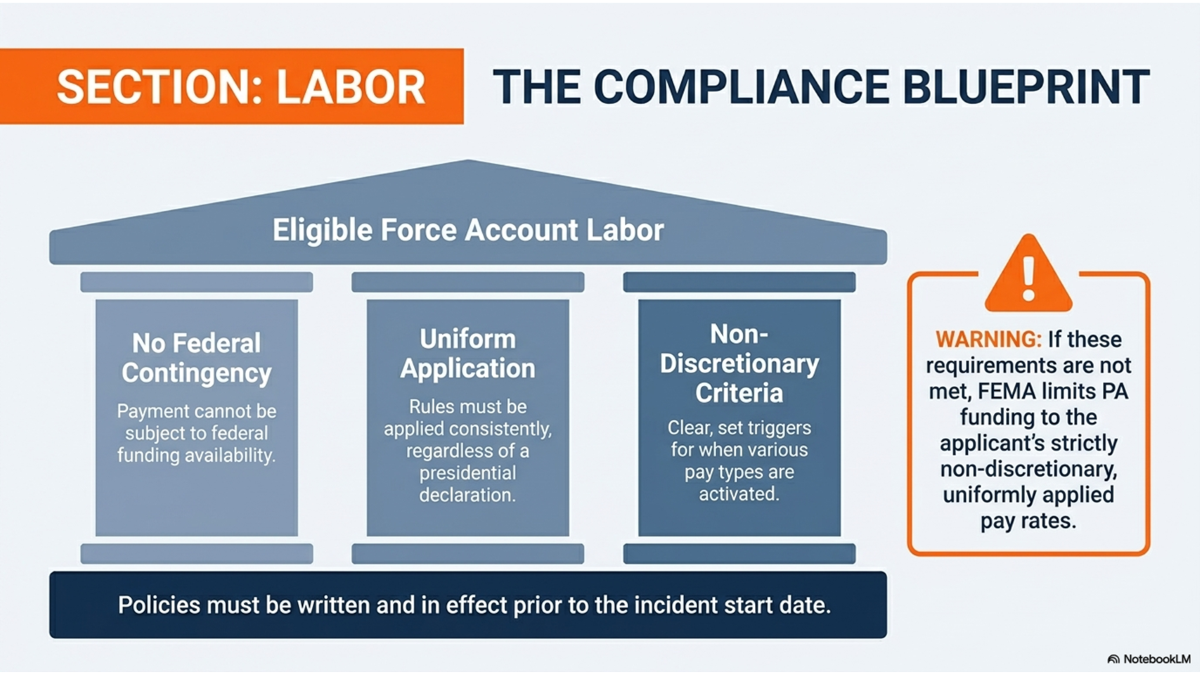

Labor is frequently the largest line item in a Public Assistance claim, making it the primary target for OIG audits. To ensure these costs are eligible, they must rest on three compliance pillars: No Federal Contingency, Uniform Application, and Non-Discretionary Criteria. These pillars exist to ensure applicants aren't creating "pay-for-funding" schemes that only exist when federal money is on the table.
First, No Federal Contingency means pay cannot be subject to the availability of federal funds.
Second, Uniform Application requires that your pay rules apply consistently across the board, regardless of whether a presidential declaration is in place.
Third, Non-Discretionary Criteria requires clear, set triggers for when pay types like overtime are activated. Critically, all policies must be "written and in effect prior to the incident start date." This is a non-negotiable requirement for eligibility.
The "So What?" Layer: The source provides a definitive "Warning": if these requirements are not met, FEMA will ignore your actual payroll costs. Instead, they will limit Public Assistance funding to your "strictly non-discretionary, uniformly applied pay rates." This often results in the total de-obligation of disaster premiums, hazard pay, or specialized overtime rates that weren't codified before the storm.Connective Tissue: Once the policy pillars are in place, we apply them to the personnel in the field using the Labor Eligibility Matrix.

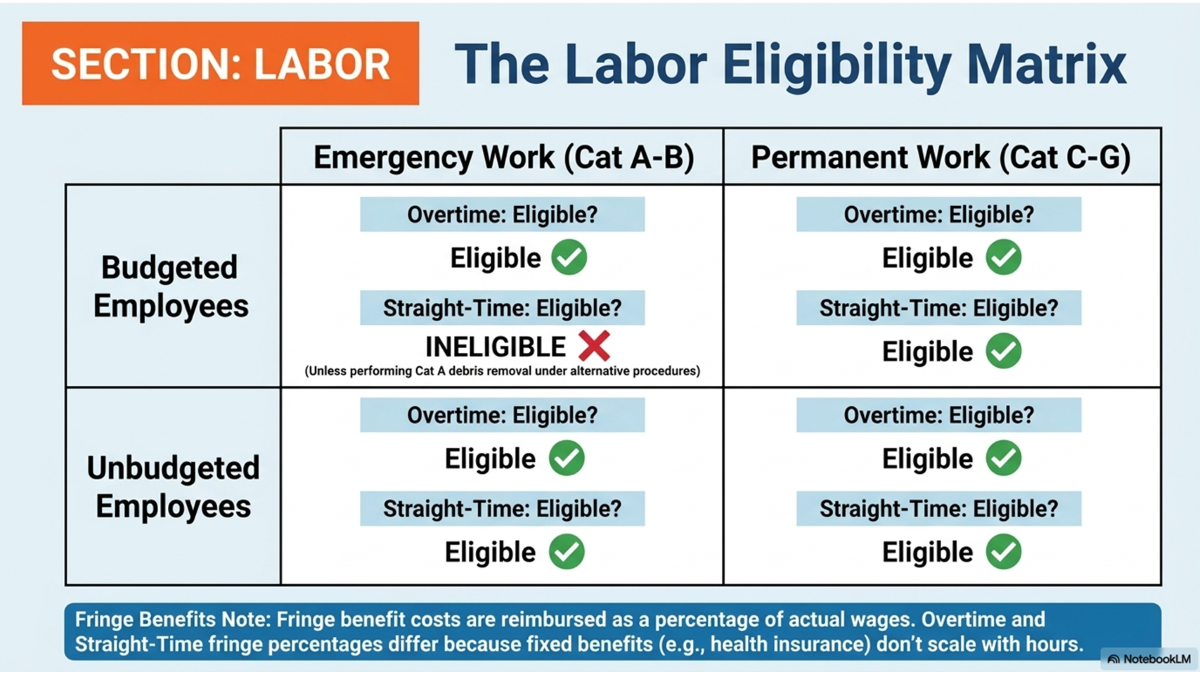

FEMA’s reimbursement logic for labor is binary: it depends on whether an employee is "Budgeted" or "Unbudgeted" and the category of work they are performing. Understanding the "Red X" on this matrix is essential for any finance officer trying to avoid a million-dollar mistake.
For Budgeted Employees (permanent staff), overtime is eligible across both Emergency (Cat A-B) and Permanent (Cat C-G) work. However, for Emergency Work, there is a critical "Red X": Straight-Time is INELIGIBLE . The only exception is for Category A debris removal performed under specific alternative procedures. For Permanent Work (Cat C-G), both straight-time and overtime are fully eligible.
Conversely, for Unbudgeted Employees (temporary or disaster-specific hires), both straight-time and overtime are eligible across all work categories.The "So What?" Layer: We must also address the "Fringe Benefits Note." Fringe benefits are reimbursed as a percentage of actual wages, but the percentages for straight-time and overtime differ . This is because "fixed benefits," such as health insurance, do not scale with additional hours worked. Failing to account for this distinction or incorrectly billing straight-time for budgeted staff during emergency response will lead to immediate "clawbacks" during the closeout phase.

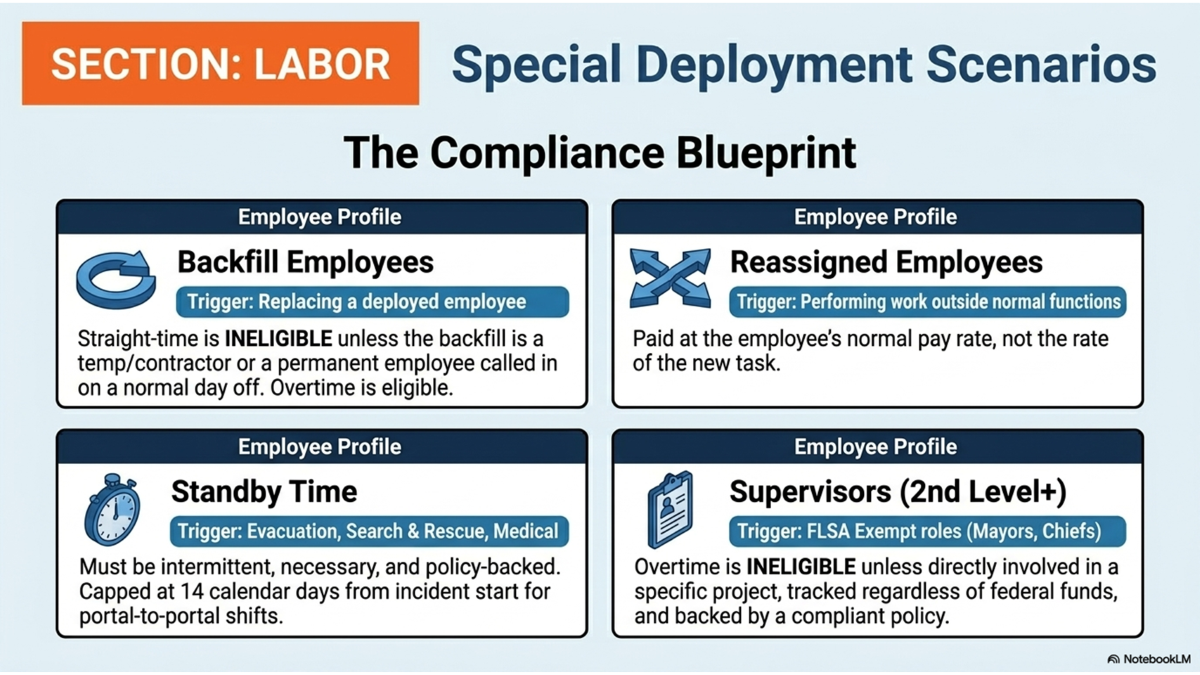

Connective Tissue: Standard hours are just the beginning; the real compliance traps lie in the special deployment profiles of your team.
Disasters force employees into non-standard roles, from backfilling positions to 24-hour standby shifts. Each profile has a specific "Trigger" that dictates eligibility. As a consultant, I've seen more funding lost to mismanaged standby time than almost any other labor category.
Backfill employees replace those deployed to the disaster; their straight-time is only eligible if they are temps, contractors, or permanent staff called in on a day off.
Reassigned employees performing work outside their normal functions must be paid at their normal pay rate, not the rate of the new task.
Standby Time (for evacuation or rescue) must be intermittent, necessary, and policy-backed, with a strict cap of 14 calendar days from incident start for portal-to-portal shifts.
Finally, Supervisors (2nd level and up) in FLSA-exempt roles find their overtime ineligible unless they are directly involved in a specific project and backed by a compliant policy.
The "So What?" Layer: The financial risk here is absolute. If you exceed the 14-day standby cap "from incident start," or if you pay a reassigned employee a higher "hazard rate" without a pre-disaster policy, FEMA will de-obligate those costs. Furthermore, for supervisors like Mayors or Chiefs, failing to track their time regardless of federal funding availability can invalidate the entire claim for their hours.Connective Tissue: Proving these complex scenarios requires a documentation strategy that scales with the size and risk of the project.

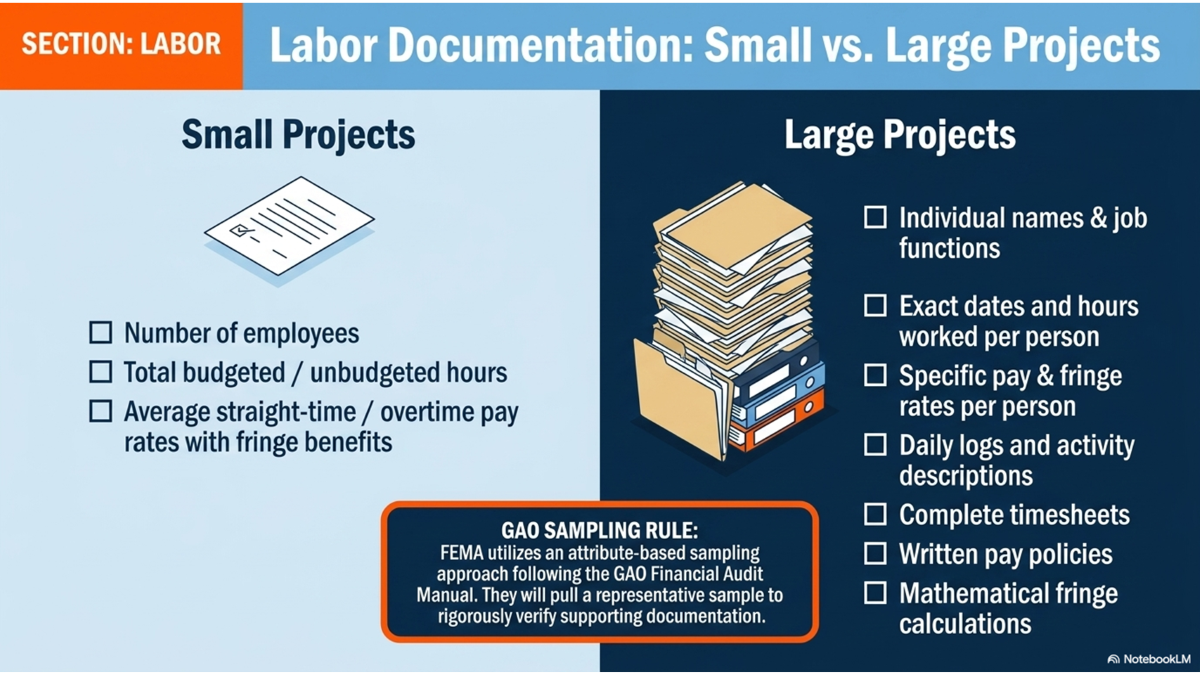

Documentation is not a "one size fits all" endeavor. FEMA’s requirements scale significantly between Small and Large projects. For Large Projects, the administrative burden is immense because FEMA applies the "GAO Sampling Rule," which tests your records for specific "attributes" of compliance.
Small Projects require high-level summaries: the number of employees, total hours, and average pay rates including fringes. However, Large Projects require exhaustive granularity: individual names, job functions, exact dates/hours per person, specific pay and fringe rates, complete timesheets, and daily activity logs.
Most importantly, FEMA utilizes an "attribute-based sampling approach" following the GAO Financial Audit Manual. They will pull a representative sample of your records to rigorously verify that the supporting documentation—down to the signature—matches your written pay policies.
The "So What?" Layer: In a Large Project, "averages" are an invitation for an audit finding. If a sampled record is missing a "mathematical fringe calculation" or a "daily log description," it is flagged as an exception. Too many exceptions in a sample can lead auditors to declare the entire labor claim "unverifiable," potentially resulting in the de-obligation of millions of dollars.Connective Tissue: Once the human element is secured, we must apply a similarly rigorous standard to our mechanical resources: Force Account Equipment.

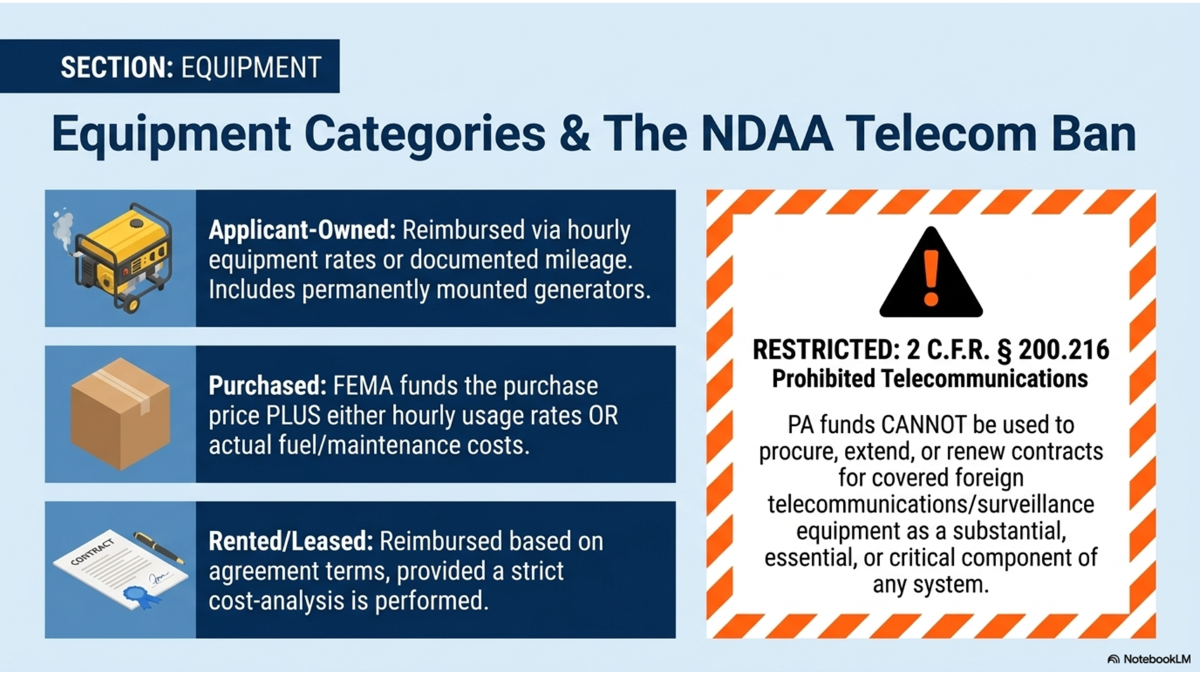

FEMA categorizes equipment into three buckets: Applicant-Owned, Purchased, and Rented/Leased. While the reimbursement methods differ, all categories are now governed by a critical security mandate: the NDAA Telecom Ban under 2 C.F.R. § 200.216.
Applicant-Owned equipment, which explicitly includes "permanently mounted generators," is reimbursed via hourly rates or mileage.
Purchased equipment is funded at the purchase price plus either hourly usage or actual fuel/maintenance. Rented/Leased equipment is based on agreement terms and a strict cost-analysis. However, the NDAA Telecom Ban is a non-negotiable prohibition on foreign-covered telecommunications or surveillance equipment. Public Assistance funds cannot be used for such equipment if it is a "substantial, essential, or critical component" of any system.
The "So What?" Layer: The "So What?" for the NDAA ban is catastrophic: the "substantial, essential, or critical component" clause means that an entire communication tower or security system could be de-obligated because of a single banned $500 camera or switch. There is no partial eligibility here; if the banned component is central to the system, the whole project's funding is rendered ineligible.Connective Tissue: For equipment that passes the security check, the next hurdle is determining the "correct" billable rate through the Decision Tree.

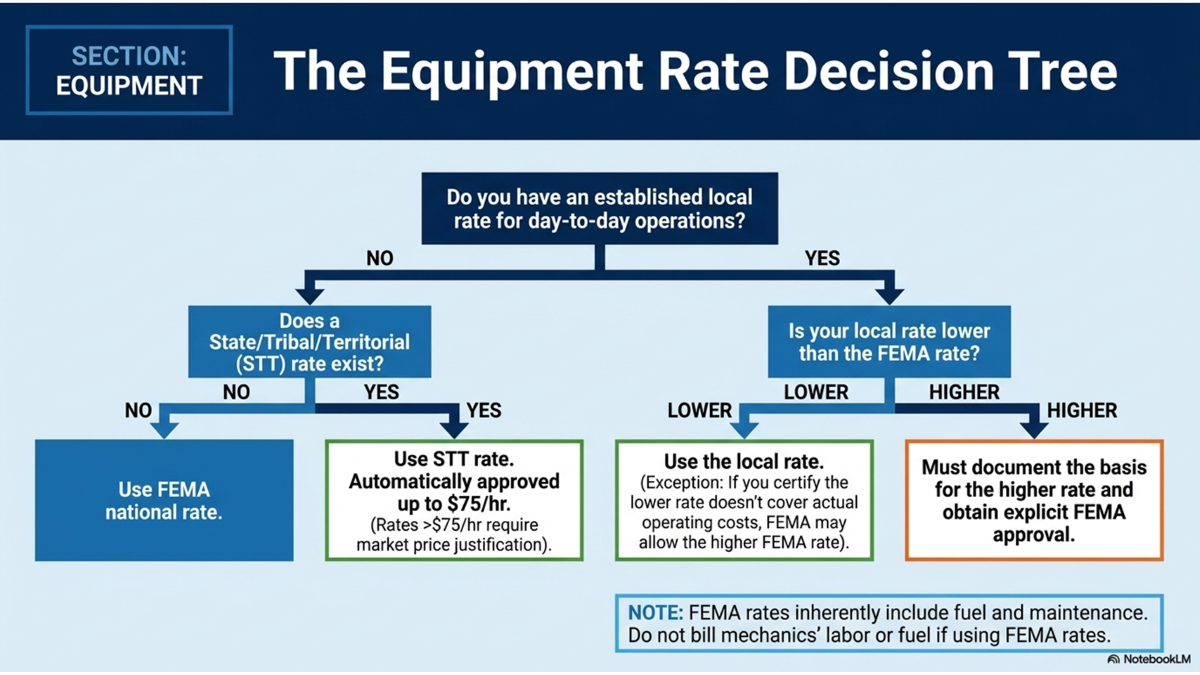

Selecting an equipment rate is a logic-driven hierarchy. You cannot simply pick the highest rate; you must follow a path that prioritizes local standards, then state standards, and finally the FEMA National Schedule.
The tree starts with your local rate for day-to-day operations. If it exists and is lower than FEMA's, you use it (unless you certify it doesn't cover costs). If your local rate is higher than FEMA's, you must document the basis and get explicit FEMA approval. If no local rate exists, move to the State/Tribal/Territorial (STT) rate .
STT rates are automatically approved up to $75/hr; anything above that requires market price justification. If no other rate exists, you default to the FEMA national rate .
The "So What?" Layer: There is a "double-dipping" trap here: FEMA national rates inherently include fuel, maintenance, and mechanics’ labor . If you use a FEMA hourly rate and then try to bill separately for a mechanic's time or a fuel invoice, FEMA will de-obligate the separate costs during the audit. This is a common and easily avoided "administrative error" that costs applicants thousands.Connective Tissue: While this logic applies to owned assets, rented or leased equipment introduces the "Prudence Rule" and the requirement for a cost-analysis.

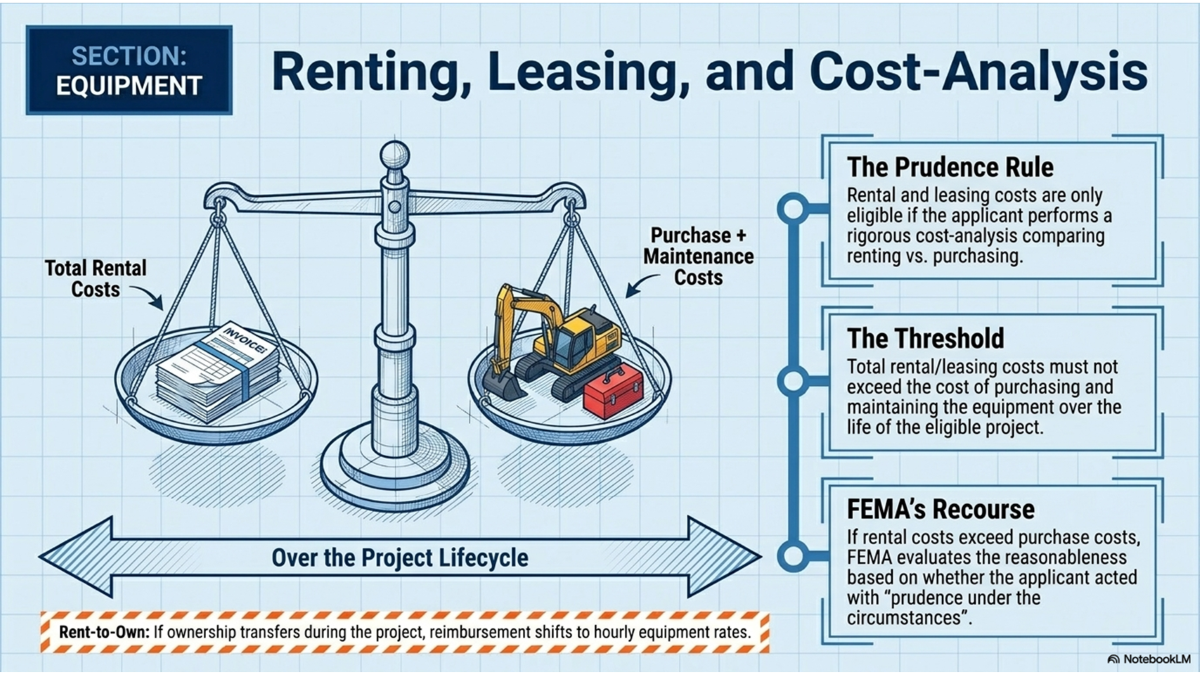

Renting or leasing equipment during a disaster might feel like the only option, but FEMA evaluates these decisions through the lens of "The Prudence Rule." You must prove that renting was a more fiscally responsible choice than purchasing the equipment outright.
FEMA requires a rigorous cost-analysis comparing renting vs. purchasing. The "Threshold" is clear: total rental or leasing costs must not exceed the cost of purchasing and maintaining that equipment over the life of the eligible project. Furthermore, if an agreement is "Rent-to-Own" and ownership transfers during the project, the reimbursement model shifts immediately from rental fees to hourly equipment rates.
The "So What?" Layer: If your rental costs exceed the purchase price, FEMA evaluates "FEMA’s Recourse." They will determine if you acted with "prudence under the circumstances." If they find you were wasteful or failed to conduct the required cost-analysis, they will limit your reimbursement to the estimated purchase price, leaving your organization to cover the excess rental costs out of pocket.Connective Tissue: Proving this prudence requires a specialized set of documents that move beyond simple invoices.

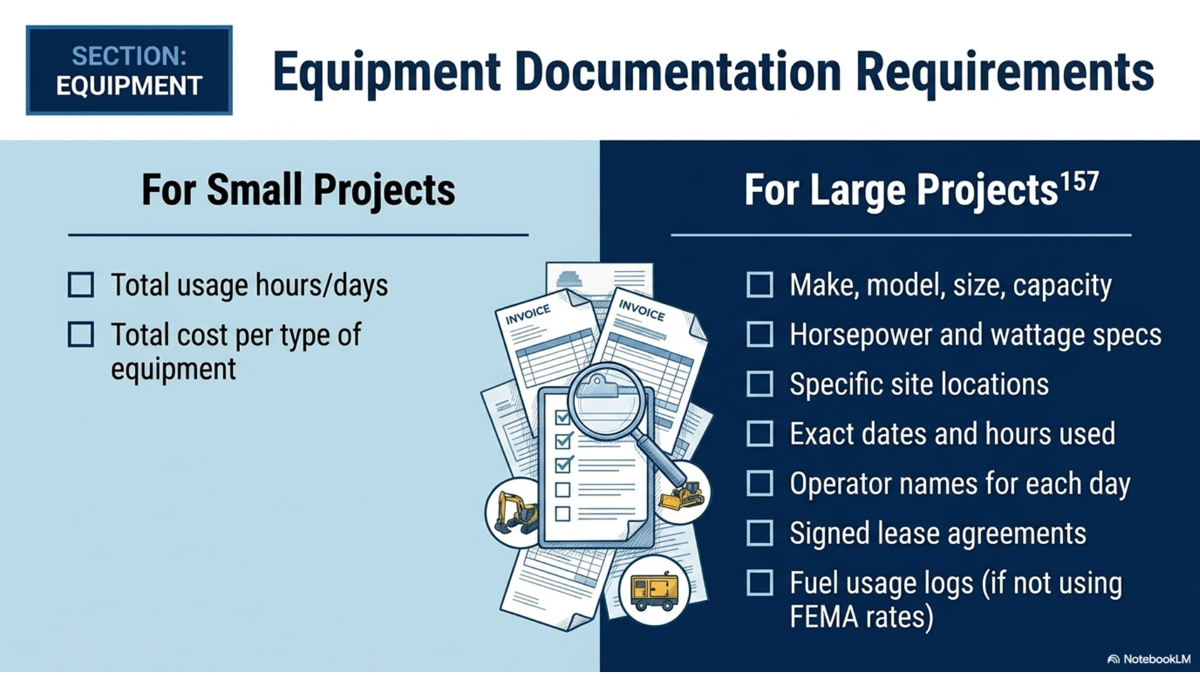

Documentation for equipment on Large Projects is a technical exercise. FEMA auditors don't just want to see that a machine was used; they want the mechanical specifications to verify that the correct rate was applied.
Small Projects require total usage hours and total cost per equipment type. Large Projects, however, demand: make, model, size, capacity, and horsepower and wattage specs . You must also provide specific site locations, exact dates/hours used, operator names for each day, and signed lease agreements. If you are not using FEMA rates, you must also provide detailed fuel usage logs.
The "So What?" Layer: The "So What?" here is $0.00. Without specific horsepower or wattage specs, FEMA cannot assign a rate from the National Schedule. This means your reimbursement defaults to zero until that data is produced. Furthermore, missing "operator names" or "site-specific locations" makes it impossible to prove the equipment was actually working on the disaster-site rather than performing routine municipal maintenance.Connective Tissue: With labor and equipment documented, we move to our final resource category: the "Supplies" or consumables that fuel the recovery.

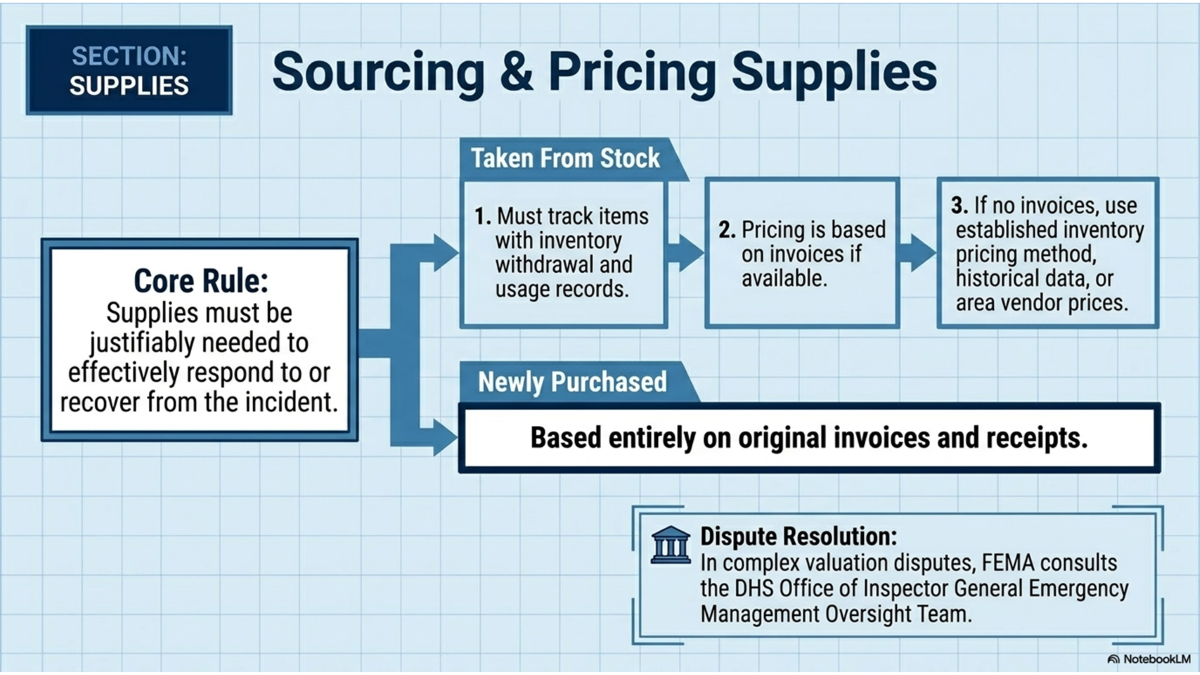

Supplies range from PPE to sandbags, and the "Core Rule" is that they must be "justifiably needed" for the incident. The complexity lies in the valuation of "Taken from Stock" items versus "Newly Purchased" items.
For items Taken From Stock , you must track them with inventory withdrawal and usage records. Pricing is based on invoices if available; otherwise, you must use an established inventory pricing method, historical data, or area vendor prices.
Newly Purchased items are simpler, based "entirely on original invoices and receipts." In the event of a complex valuation dispute, FEMA will consult the DHS Office of Inspector General (OIG) Emergency Management Oversight Team .
The "So What?" Layer: Receipt retention is the single most important operational task for supplies. Because newly purchased items are based entirely on invoices, a lost receipt is a lost reimbursement. For stock items, the lack of a pre-disaster inventory pricing method can lead to a protracted dispute with the DHS OIG that delays funding for the entire project.Connective Tissue: Documentation logic is useless if you've classified the resource in the wrong category to begin with. We must distinguish between an "Asset" and a "Supply."

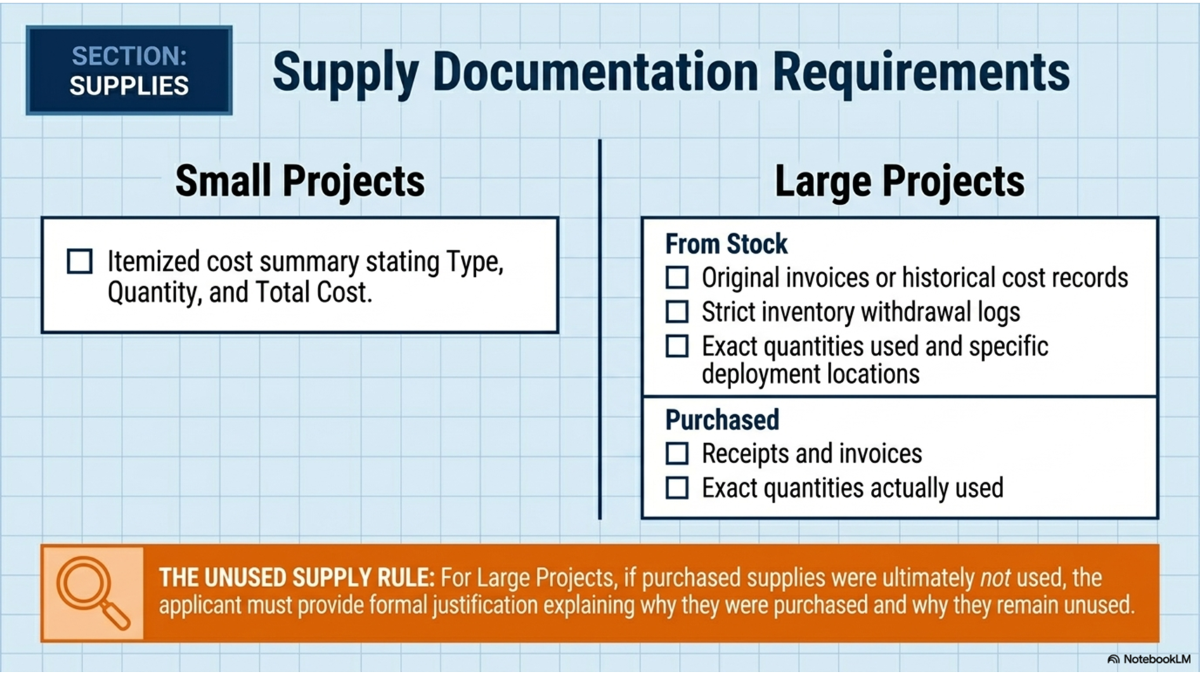

The documentation for supplies scales with project size, but it includes a unique financial trap: "The Unused Supply Rule." This rule requires a formal accounting of everything you bought but didn't consume.
Small Projects require an itemized cost summary of type, quantity, and cost. Large Projects require original invoices, "strict inventory withdrawal logs," and exact quantities used at specific deployment locations. If you have purchased supplies that were ultimately not used on a Large Project, you must provide a formal justification explaining why they were purchased and why they remain unused.
The "So What?" Layer: The "Unused Supply Rule" is a trigger for funding reduction. If the aggregate total of all unused residual supplies across all your projects exceeds $10,000, FEMA will reduce your funding. Formal justification is your only defense, but even then, exceeding that $10,000 threshold invites a secondary review of your project's overall scale and necessity.Connective Tissue: To navigate these thresholds, you must first apply the Classification Matrix to determine if an item is an asset or a supply.

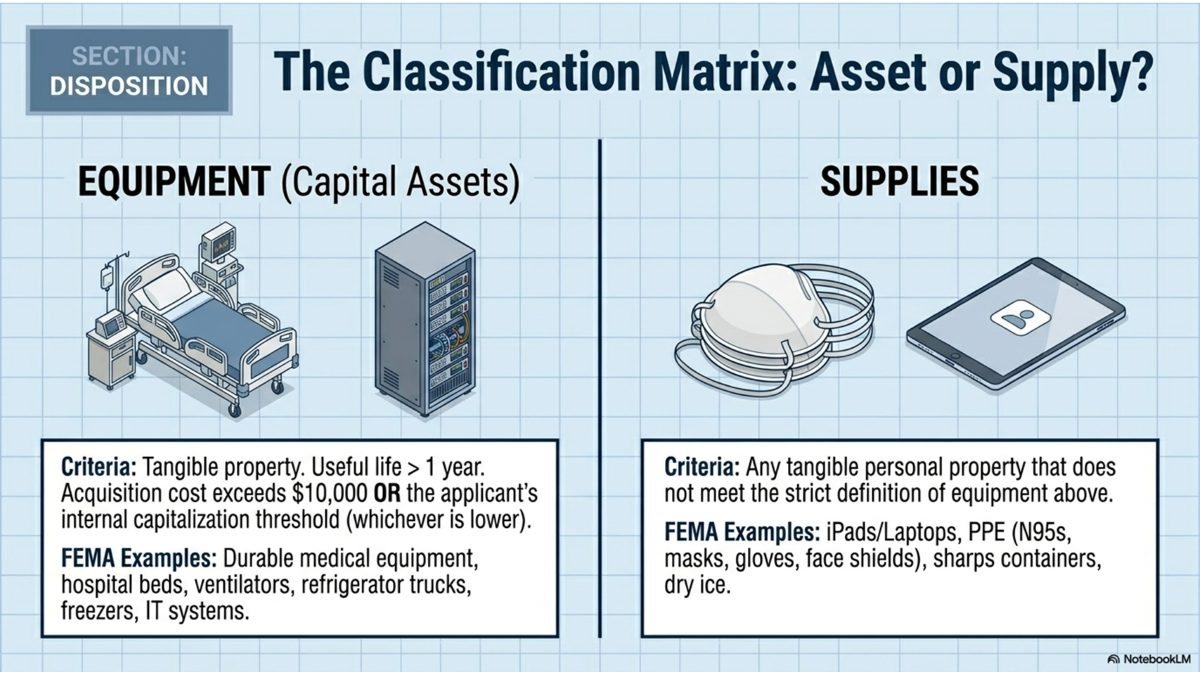

Misclassifying an item is a major compliance risk that leads to the application of the wrong documentation standards and disposition rules. The Classification Matrix uses two primary criteria: useful life and acquisition cost.
Detailed Narrative: Equipment (Capital Assets) are tangible property with a useful life of more than one year and an acquisition cost that exceeds $10,000 (or your lower internal threshold). FEMA examples include ventilators, freezers, hospital beds, refrigerator trucks , and IT systems.
Supplies are any tangible personal property that doesn't meet the equipment definition. This includes PPE (N95s, masks, gloves, face shields), sharps containers, iPads/Laptops, and dry ice .
The "So What?" Layer: Treating a $12,000 ventilator as a "supply" means you'll miss the required capital asset disposition rules, leading to an audit failure. Conversely, treating a "sharps container" as equipment creates an unnecessary administrative burden of tracking "useful life" for an item meant to be consumed. Precision here saves hundreds of hours of administrative correction later.Connective Tissue: Once classified, we enter the final financial reconciliation of the project: The Disposition Financial Workflow.

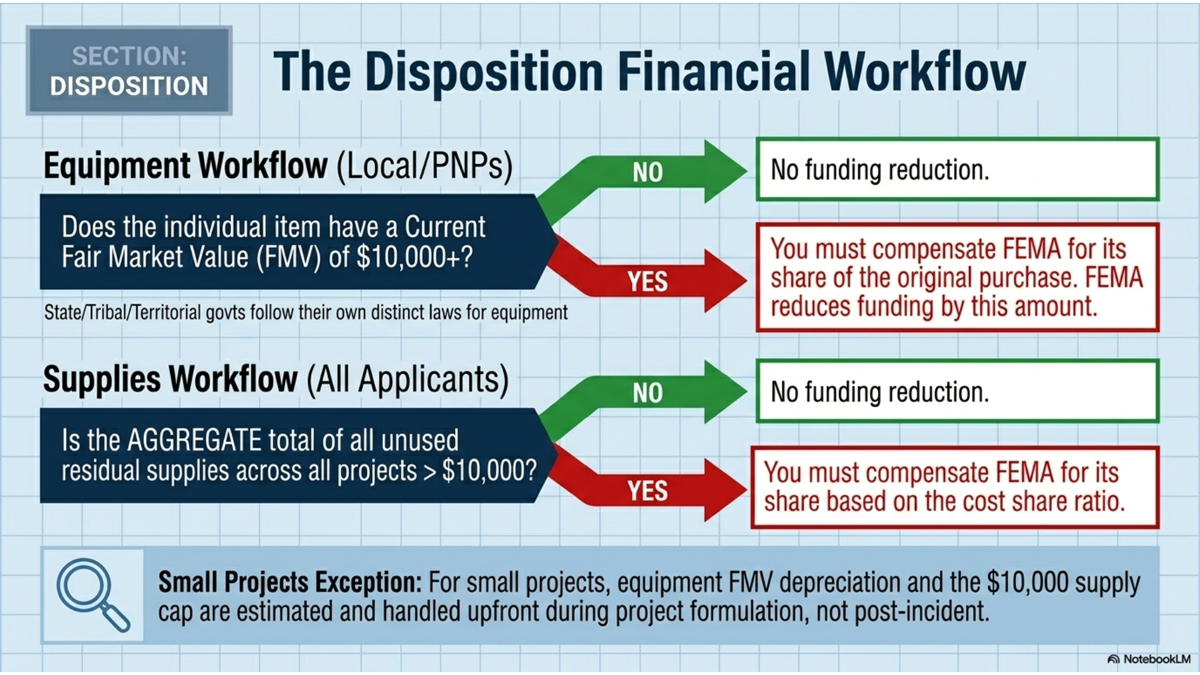

Disposition is the process of answering the question: "Do we owe FEMA money back?" The rules differ significantly depending on whether you are a Local/PNP applicant or a State/Tribal/Territorial (STT) government.
For Local/PNPs , the Equipment Workflow triggers if an individual item has a Current Fair Market Value (FMV) of $10,000 or more; if so, you must compensate FEMA. However, STT governments follow their own distinct laws for equipment .
For Supplies , the $10,000 threshold applies to all applicants and is based on the AGGREGATE total of all unused residual supplies across all projects. Note the Small Projects Exception : for these, FMV depreciation and supply caps are estimated and handled upfront during project formulation, not post-incident.
The "So What?" Layer: The "So What?" for supplies is the word "Aggregate." You cannot hide unused stock by spreading it across multiple small projects to keep each under $10,000. FEMA’s aggregate check is designed specifically to capture the value of large-scale leftover stockpiles. Failing to calculate FMV correctly results in a surprise funding reduction during final closeout.Connective Tissue: We conclude this playbook with your ultimate defense tool: The Master Checklist.

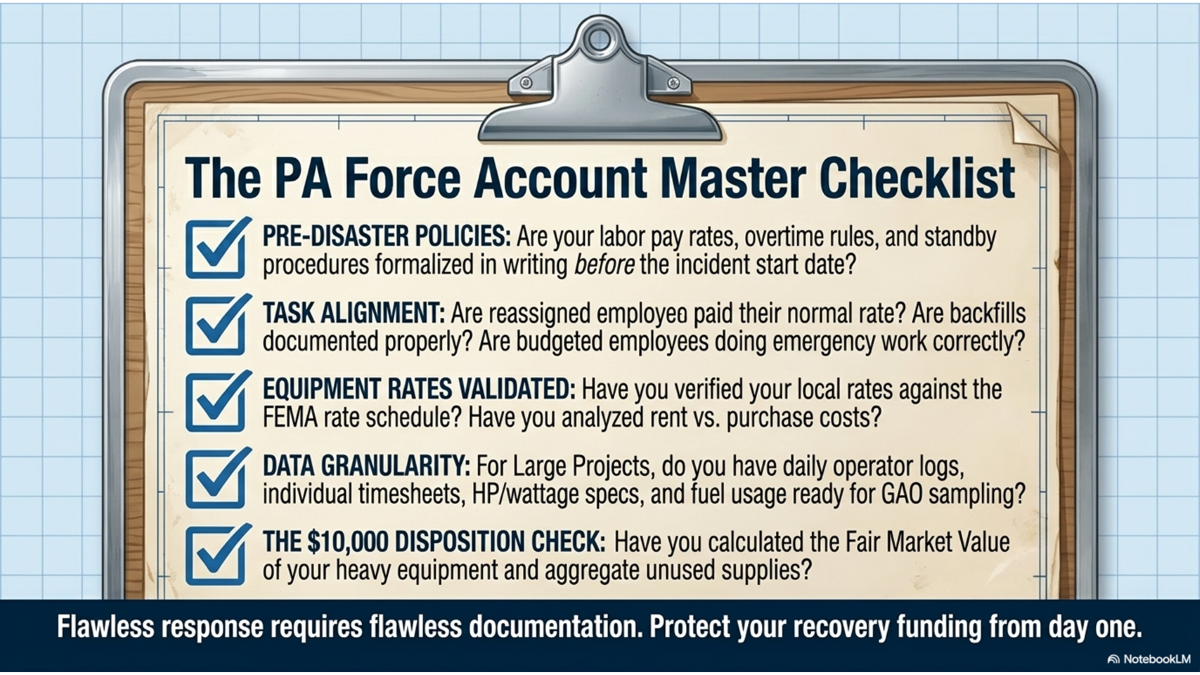

The PA Force Account Master Checklist distills hundreds of pages of PAPPG policy into five critical "Go/No-Go" checks. As a consultant, I recommend this be the first and last thing reviewed by your project managers to ensure total audit-readiness.
Detailed Narrative: The checklist requires verification of:
